You are viewing this article in the AnnArbor.com archives. For the latest breaking news and updates in Ann Arbor and the surrounding area, see MLive.com/ann-arbor
Posted on Fri, Sep 9, 2011 : 5:58 a.m.

Ann Arbor streets to get additional $550,000 facelift before construction season is over

By Ryan J. Stanton


Residents along Spring Street protested the decay of their neighborhood street earlier this year and their voices were heard.

Ryan J. Stanton | AnnArbor.com

Ann Arbor residents can expect repairs to a several more city streets before the year is over after action taken by the City Council this week.

The council voted 10-0 on a $550,000 contract amendment with Barrett Paving Materials Inc. to increase the scope of the city's street resurfacing program for 2011.

The funds for the extra work are coming from a variety of sources, including the city's street millage. The millage is up for renewal in November along with a separate request for a slight increase to fund sidewalk repairs with street millage money going forward.

Monday's action amends the original $3.7 million contract with Barrett Paving, which included resurfacing or reconstructing six major streets and six residential streets.

As of mid-July, the program is ahead of schedule, which offered the opportunity to resurface more streets before the end of the construction season, according to Homayoon Pirooz, head of the city's project management unit.

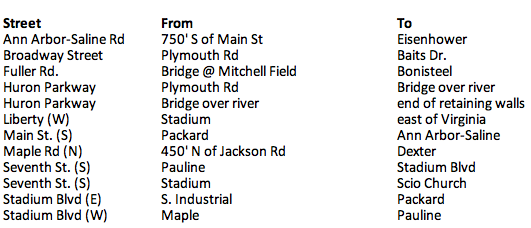

Pirooz offered an overview of the additional street work in a memo to council. He said that includes work on Spring Street, Miller Avenue, North Division Street and Oxford Street, as well as $80,000 worth of crack sealing at the following locations:


For more detailed descriptions of the projects, read Pirooz's memo here.

In a recent email newsletter sent to residents, Council member Sabra Briere, D-1st Ward, shared a report on the street millage's revenue and expenditures (download it here).

Council Member Mike Anglin, D-5th Ward, was absent from Monday's meeting.

Ryan J. Stanton covers government and politics for AnnArbor.com. Reach him at ryanstanton@annarbor.com or 734-623-2529. You also can follow him on Twitter or subscribe to AnnArbor.com's e-mail newsletters.
